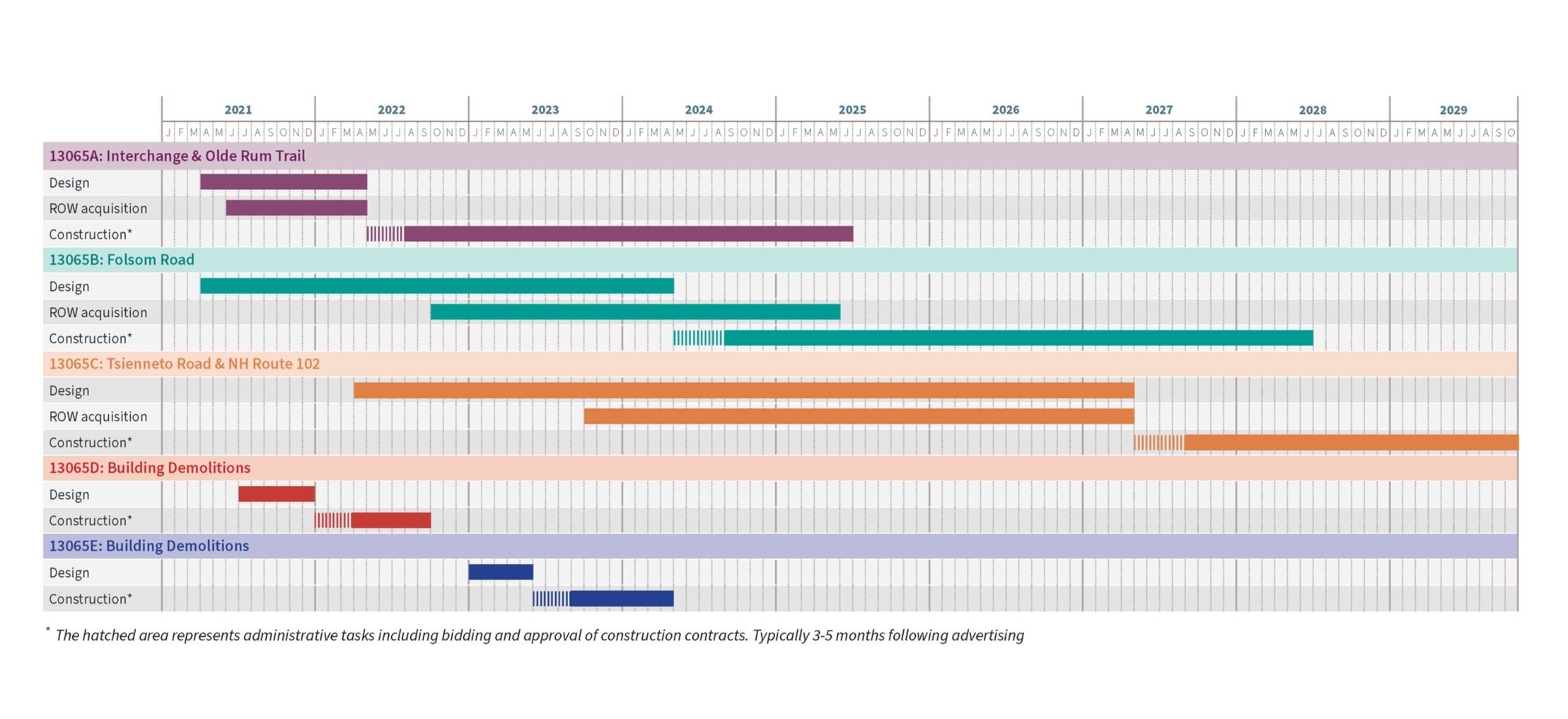

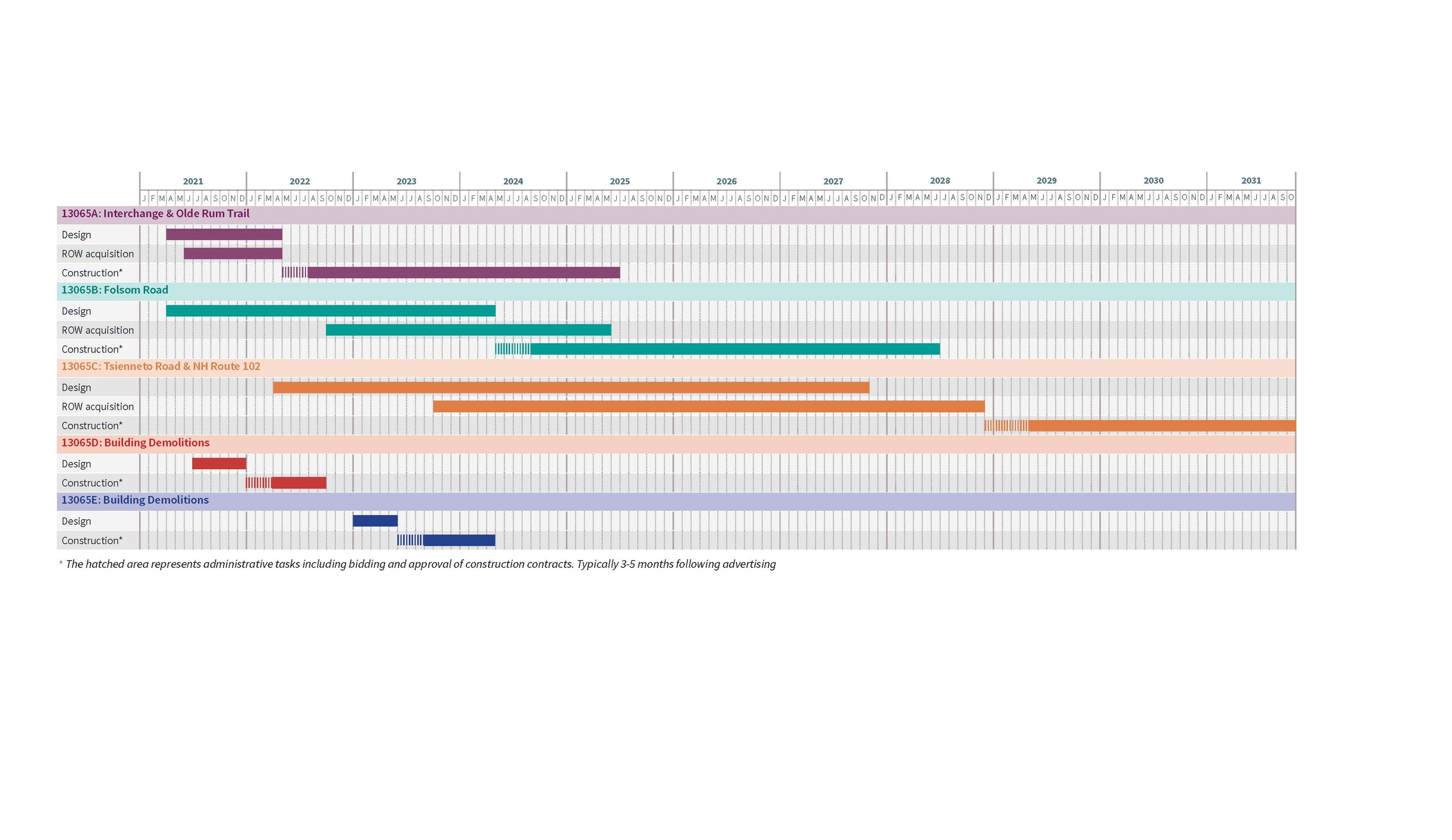

Project Schedule

The overall project consists of many projects that include design, right-of-way, and construction. The schedule for each is listed below.

Current schedule for the I-93 Exit 4A project, showing projected timelines for I-93 Exit 4A Interchange & Old Rum Trail (13065A), Folsom Road (13065B), Tsienneto Road & NH Route 102 (13065C), and the Building Demolition project. All schedules are subject to change based on weather and other factors.

13065: Right-of-Way Schedule

Milestone

Date or Timeframe

Acquisitions

See individual projects below

13065A: I-93 Exit 4A Interchange & Old Rum Trail Schedule

Milestone

Date or Timeframe

Design

April 2021 – April 2022

Right-of-way acquisition

June 2021 – April 2022

Construction

2022 – 2024

13065B: Folsom Road Schedule

Milestone

Date or Timeframe

Design

April 2021 – Spring 2024

Right-of-way acquisition – up to 65 parcels

October 2022 – Spring 2024

Construction

2024 – 2027

13065C: Tsienneto Road & NH Route 102 (Chester Road) Schedule

Milestone

Date or Timeframe

Design

March 2022 - Spring 2025

Right-of-way acquisition – up to 100 parcels

October 2023 – Spring 2025

Construction

2025 – 2027

13065D: Building Demolition Schedule

Milestone

Date or Timeframe

Design

Summer 2021 – Winter 2021

Construction

Spring 2022 – Fall 2022

13065E: Building Demolition Schedule

Milestone

Date or Timeframe

Design

Spring 2023 – Summer 2023

Construction

Summer 2023 – Spring 2024
